Condominium Perimeter Fence Security in Malaysia.

REFERENCEIN-22
TERRITORYEVERY LAYER, ONE CONTRACTOR
ISSUED
EXTENT1,919 WORDS
READING8 MIN
DRAWN BYOCCHIO TEC SDN BHD

QUESTION ANSWEREDThe committee is holding a quotation for perimeter fencing after a break-in: what will it actually detect, and what has to be approved before any of it can be switched on?

IN SHORT

A condominium’s boundary is common property, so the fence and anything fixed to it are the management body’s decision and its duty to keep in repair. An electric fence is not a product you buy: it is a regulated electrical installation needing two separate written approvals from the Energy Commission, construct and then use, with neighbour and local-authority consents obtained first.

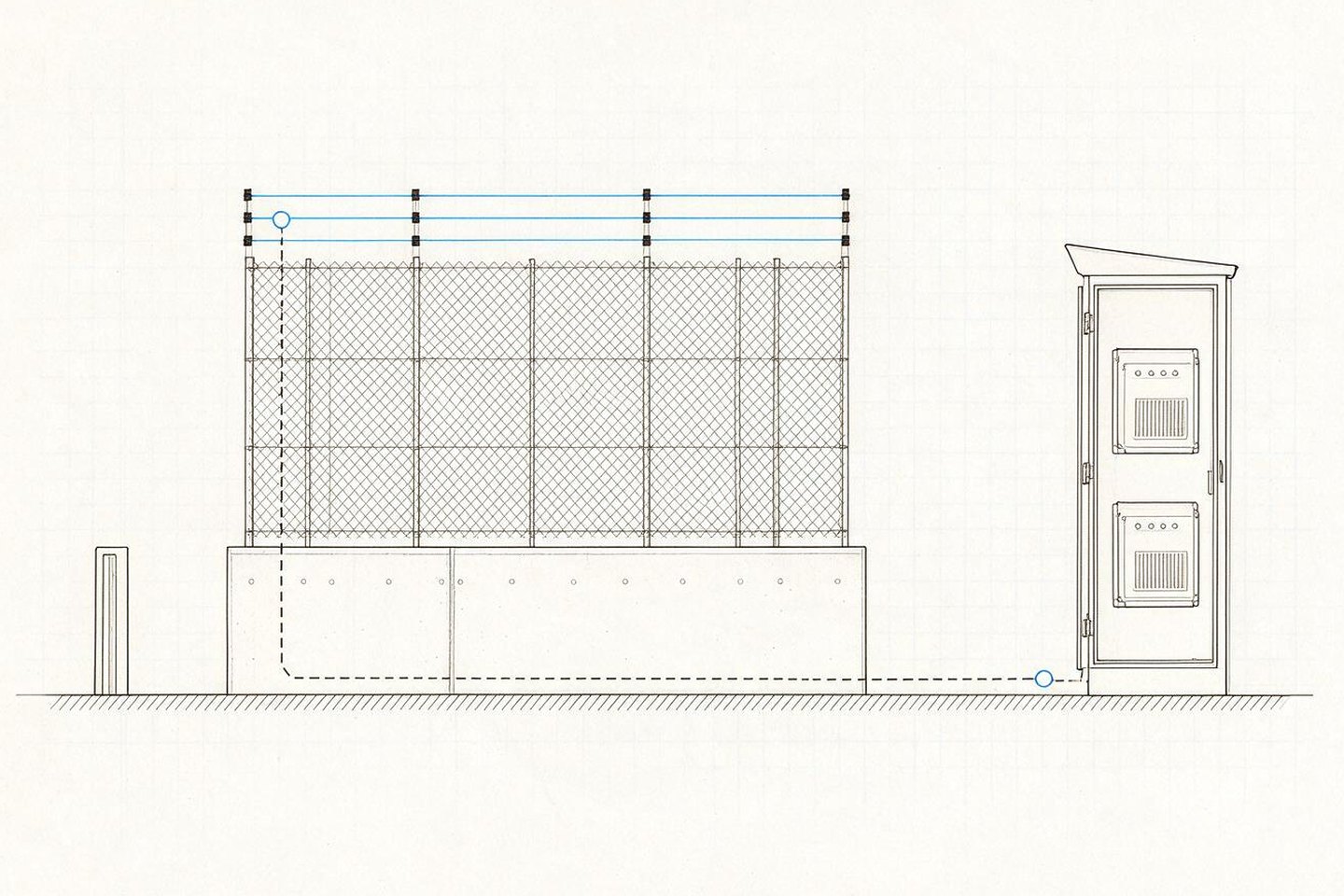

Elevation of a condominium boundary: a low wall carrying a mesh fence, pulsed wires on insulator standoffs along the top drawn in blue, and a dashed circuit running to a cabinet at the right housing the energizer.
The wires are the regulated part; the barrier below them is the conditionT-01
KEY TAKEAWAYST-02
  • 01The boundary is common property, so it is the management body’s, not an owner’s, and the management body answers for keeping it in repairSMA 2013
  • 02An electric fence needs written approval to construct AND written approval to useENERGY COMMISSION
  • 03Neighbour, local-authority and utility consents come before the applicationNOT AFTER
  • 04A competent person must re-inspect the fence at least once every two yearsA STANDING DUTY
  • 05Detection is probabilistic: specify something testable, not a vendor’s percentageAND NAME WHO ASSESSES
§01

Who owns the condominium’s boundary, and who decides about it?

The management body does, in almost every case. Under the Strata Management Act 2013, common property in a subdivided building is so much of the lot as is not comprised in any parcel, including any accessory parcel or provisional block on a certified strata plan, and is used or capable of being used by the occupiers of two or more parcels. A boundary wall and the fence on it answer that description.

The duty follows the ownership. A management corporation (MC) must properly maintain and manage the subdivided building and the common property and keep it in a state of good and serviceable repair; a joint management body (JMB) carries the same duty before subdivision. The perimeter is therefore not the guard company’s equipment and not an owner’s private project. It is a layer the building itself has to own, which is the practical case for every layer, one contractor rather than four suppliers and nobody answering.

§02

Why does a perimeter alarm go off when nobody is there?

Because perimeter intrusion detection (PIDS) is a probability, not a switch. The US Department of Homeland Security’s guidance on intrusion detection sensors puts it plainly: since sensors interact with their environments, all sensor systems are vulnerable to nuisance alarms, and “a nuisance alarm is a legitimate detection caused by something other than an intruder.” Exterior sensors are likely to be affected by weather and animal activity.

The consequence is the part committees skip. Because the cause of an alarm is not always discernible, an alarm assessment capability has to be designed in so that security staff need not respond to every alarm. In a condominium that means a camera on the zone that alarmed and somebody positioned to look at it — a question about the security control room and about alarm handling, not about the fence. A boundary alarm nobody assesses only trains the guards to ignore a bell.

The same guidance is clear that no sensor is absolutely reliable, and that a design should use multiple sensors and sensor types to lower the potential for defeat. One technology along the whole boundary is the easiest to price and the easiest to walk through.

§03

Is an electric fence legal at a Malaysian condominium?

Yes, and far more tightly regulated than most committees expect. The Energy Commission (Suruhanjaya Tenaga) states that installing an electric fence requires approval both to construct and to use, to protect users and the public. Its installation guide exists, in its own words, to address electrical accident cases involving fences installed otherwise than to the prescribed standard, and sets the method by reference to MS IEC 60335-2-76, the particular requirements for electric fence energizers.

One detail is worth reading twice. The guide describes the premises that typically install electric fences as those carrying out agricultural activity, or security control such as the military and the energy and water utilities. A residential strata building is nowhere in that description — and the regime binds it in full anyway.

LIMITS THE COMMISSION APPLIES TO AN ELECTRIC SECURITY FENCET-03
RequirementWhat the standard setsWhat it decides on site
Impulse repetition rateShall not exceed 1 HzThat a contact is a shock, not a hold
Energy per impulseNot more than 5 joules, energy-limited typesWhether the equipment is a certified type
Supply to the fenceNever from two separate energizers, nor from independent fence circuits of one energizerHow zones may be split along a boundary
Separation from the publicA physical barrier, at least 1.5 metres in the worked examplesWall height, and where the wires can start
Warning signageOn the pulse conductor, at most 10 metres apartWhat residents and passers-by see
§04

What does the approval actually involve, in order?

Seven steps, and the consents come before the application, not after. The Commission’s own stated sequence runs: consents from neighbours, the local authority and the utilities; a registered electrical contractor; an application with an engineer-signed diagram and accredited energizer test reports; the approval-to-construct letter; an area-office inspection; then written approval to use.

  1. Obtain letters of consent — adjoining or nearby neighbours, the local authority, the utilities and others — before submitting anything.
  2. Appoint an electrical contractor registered with the Commission; no one else may carry out the work.
  3. Apply online, with a labelled structural diagram and specification signed by a Competent Electrical Engineer registered with the Commission, who takes full responsibility for the installation.
  4. Attach the energizer’s certification and test reports to IEC 60335-2-76 from an IECEE CB Scheme, APLAC or ILAC accredited laboratory.
  5. Wait for the approval-to-construct letter. Only once it is issued may the contractor begin.
  6. When the work is finished, a Commission area-office officer inspects the premises.
  7. Only once the written approval has been obtained from that office may the fence be commissioned.

Two things are easy to miss. Where a fence is planned to run close to a site boundary, the relevant government authority should be consulted before installation begins — and a condominium boundary is, by definition, close to one. The applicant also remains responsible for any other applicable legislation, local-authority law being the Commission’s own example. The approval carries no fee, so the process costs time and drawings; the equipment, the barrier and the standing inspections are what reach the meeting that approves the money.

§05

What must the fence carry once it is up, and who keeps it that way?

A duty that does not end at handover, and this is the half no product page mentions. The owner must appoint a competent person, at minimum an Electrical Supervisor, to inspect the fence at least once every two years and submit that report to the Commission’s area office. The Commission will cancel the approval letter in stated circumstances, including where the installation is no longer used or no longer safe.

WHO CARRIES WHAT, AFTER THE FENCE IS LIVET-04
ObligationSourceWhose it is
Keep the installation in good and working orderElectricity Regulations 1994The owner, management, licensee or occupier
Re-inspect the fence at least every two yearsEnergy Commission guideA competent person the building appoints
Check and test the installation every five yearsElectricity Regulations 1994A competent person, non-domestic installations
Carry out the electrical work at allElectricity Regulations 1994A registered Electrical Contractor, no one else

Keeping the installation in good and working order is a duty of the Electricity Regulations 1994 themselves, and contravening those Regulations carries, on conviction, a fine of up to five thousand ringgit or up to one year of imprisonment, or both. The guide’s two-yearly inspection is separate, and belongs in the maintenance contract rather than with whoever installed the fence, in the same way proof of condition belongs there. Signage, barrier and zone boundaries are also what a patrol round can confirm are still in place.

§06

What should a committee settle before anyone prices this?

Four things, in writing, before a quotation is sought. Which parts of the boundary are in scope, and whether any run close enough to a neighbour to need a consent letter. Whether an electric fence is in contemplation at all, because that answer changes the programme, not just the price. Who assesses an alarm at three in the morning, and from where. And who carries the two-yearly inspection once the installer has gone.

The Department of Statistics Malaysia recorded property crime up 12.4 per cent to 47,188 cases in 2024; house break-in and theft fell 1.8 per cent, but 77.6 per cent of those cases happened at night — which is why the three-in-the-morning question matters.

On detection, resist the percentage. The US Department of Homeland Security’s guidance notes that the probability of detection depends on the sensors chosen, the installation, the sensitivity settings, local environmental conditions, maintenance and the assumptions made about intruders, and that “it is better to specify parameters that are testable, instead of relying on a specific number”. Holding detection over a system’s life is an ongoing process of maintenance and training, not a figure in a brochure. A testable line belongs in the operational levels of a scope of works, zone by zone.

Occhio Tec is an Extra Low Voltage contractor established in 2012, designing, installing and maintaining CCTV, access control, video intercom, structured networking and perimeter intrusion for condominiums in Mont Kiara, Bangsar and KLCC, including systems another contractor installed. MicroEngine appointed it an Authorised System Installer in 2014; Panasonic Malaysia an Authorised Strategic Partner for ELV works in 2015. Which of this applies to one boundary cannot be read off a drawing: request a site survey, or message +60 11-6494 4931.

F-A

Questions about a condominium perimeter fence

Q-01Can an owner put an electric fence on their own balcony or on the boundary wall?

Not on their own, wherever it is fixed. The Energy Commission requires written approval both to construct and to use, whoever is paying. A boundary wall is also common property under the Strata Management Act 2013 — part of the lot outside any parcel, used by the occupiers of two or more parcels — so it is the management body’s, not an individual owner’s.

Q-02Does the Energy Commission charge for the electric fence approval?

No fee is charged for the approval itself. The cost sits elsewhere: the consent letters needed from neighbours, the local authority and the utilities before applying, signed diagrams from a registered Competent Electrical Engineer, and energizer certification from an accredited laboratory.

Q-03Our perimeter alarm goes off every night. Is the system faulty?

Not necessarily. A nuisance alarm is a legitimate detection caused by something other than an intruder, and all sensor systems are vulnerable to them because sensors interact with their environments; exterior sensors are likely to be affected by weather and animal activity. The answer is usually an alarm assessment capability rather than a less sensitive fence.

Q-04Who has to inspect the electric fence after it is installed?

A competent person the building appoints, at minimum an Electrical Supervisor, at least once every two years, with the report submitted to the Energy Commission’s area office. The duty to keep the installation in good and working order sits with the owner, management, licensee or occupier, and only a registered Electrical Contractor may carry out the work.
